| 2024 Completed Activities |
- All-way stop installation at Centre Street & Main Street.
- Pedestrian Crossover upgrade at Centre Street & Mill Street.
- Utility investigations and utility relocation designs by Others (Hydro One, Rogers & Bell).
- 2024 Utility relocation construction along Centre Street (Phase 1).
|
| Week of May 26, 2025 |
- Bank Street utility relocation survey layouts completed.
|
| Week of June 2, 2025 |
- 1:1 Business Consultations were completed in May/ June to discuss economic development support, business operations and ways to mitigate construction impacts to businesses.
- The roadworks and landscaping construction contract documents have been tendered for contractor bidding.
|
| Week of June 9, 2025 |
- Public communications issued.
|
| Week of June 16, 2025 |

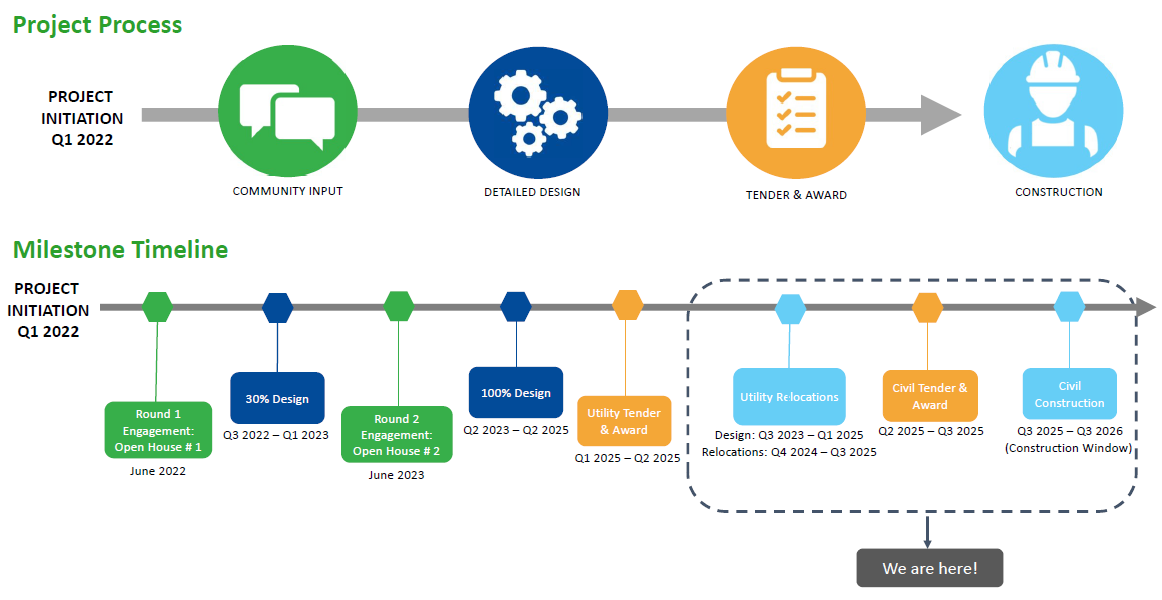

- Utility relocation construction has commenced and will continue from mid-June 2025 until Q3 2025.
- Utility relocation construction has commenced along Bank Street, the project team has been in coordination with adjacent property owners.
- Underground service conduit has been installed by the contractor on private property (Bank St).
|
| Week of June 23, 2025 |
- Layouts on-site for proposed hydro pole locations (Centre St and Main St).
|
| Week of June 30, 2025 |
- Layouts on-site for proposed hydro pole locations (Centre St and Main St).
|
| Week of July 7, 2025 |
- Hydro One's contractor, Kawartha Utility Services (KUS), are mobilizing to the project area.
- Locations include Alice Street/ Mount Albert Road, Mill Street and Main Street.
- Upgrades to existing hydro utilities.
- Excavation and Hydro-Vac works.
|
| Week of July 14, 2025 |
- Continued layouts on-site for proposed hydro pole locations (Centre St and Main St).
- Relocating existing trash receptacles to accommodate Hydro One work on Centre Street.
|
| Week of July 21, 2025 |
- Hydro One's contractor, Kawartha Utility Services (KUS), are starting construction on hydro poles, beginning with work along Centre Street and Main Street.
|
|
Week of July 28, 2025
|
- Hydro One's contractor, Kawartha Utility Services (KUS), will continue with construction on hydro poles along Centre Street and Main Street.
- Hydro One or it’s contractor may contact you to arrange an outage to allow for the transfer of your service to the new utility lines.
- Civil construction contract awarded.
|
|
Week of August 4, 2025
|
- No works are scheduled for this week.
|
|
Week of August 11, 2025
|
- Hydro One and their contractor, Kawartha Utility Services, will continue with the installation of new poles along Centre Street.
- In order to ensure Hydro One has full access to all work locations, we respectfully request that no vehicles be parked along Centre Street during this time. We appreciate your understanding.
- Hydro One or it’s contractor may contact you to arrange an outage to allow for the transfer of your service to the new utility lines.
|
|
Week of August 18, 2025
|
- Hydro One and their contractor continue with the conversion of overhead utilities to underground on Bank St. Please note that the road is open to Local Traffic only.
- Hydro One or it’s contractor may contact you to arrange an outage to allow for the transfer of your service to the new utility lines.
- Crews and service providers continue to transfer lines to the new poles on Main St. and Centre St.
|
|
Week of August 25, 2025
|
- Hydro One and their contractor continue with the conversion of overhead utilities to underground on Bank St. Please note that the road is open to Local Traffic only.
- Hydro One or it’s contractor may contact you to arrange an outage to allow for the transfer of your service to the new utility lines.
- Crews and service providers continue to transfer lines to the new poles on Main St. and Centre St.
|
| Week of September 1, 2025 |
- Pre-construction survey inspections underway by GPM Environmental.
- With Hydro One installations complete, utility coordination is underway with Rogers and Bell.
|
| Week of September 8, 2025 |
- Pre-construction survey inspections underway by GPM Environmental.
- Utility coordination is underway with Rogers and Bell.
|
| Week of September 15, 2025 |
- Pre-construction survey inspections underway by GPM Environmental.
- Utility coordination is underway with Rogers and Bell.
|
| Week of September 22, 2025 |
- The Revitalization construction contractor (Primrose) will begin mobilizing to the area later this week.
- Initial activities through the contractor will begin on Main Street and include construction surveys/layouts, traffic control measures, vacuum excavations, silt fencing and tree protection zones.
- The Town parking lot on the north side of Main Street, 75m west of Centre Street will be temporarily closed to the public as of Wednesday Sept 24, 2025 until Fall 2026. This parking lot will be used by the contractor for their trailer, equipment and materials. Users of the parking lot may choose to park at alternate Town parking lots including the Mount Albert Community Centre or Vivian Creek Park.
|
| Week of September 29, 2025 |
- The contractor is continuing to install tree protection zones, signage, surveys/layouts and traffic control measures along Main Street.
- Minor tree trimming and grubbing along Main Street.
- Later this week, preparation for Main Street road and storm sewer works.
|
| Week of October 6, 2025 |
- The contractor is continuing to complete surveys/layouts onsite along Main Street.
- Removal limits for curb, road and sidewalks will be painted out along Main Street.
- Main Street driveway culverts will be inspected.
|
| Week of October 13, 2025 |
- Hydro-vac excavations continue, to mitigate underground conflicts.
- Concrete storm structures are being delivered to the project site.
|
| Week of October 20, 2025 |
- Driveway culvert and minor ditch cleanouts to occur along the west half of Main Street.
- Excavations will begin on the east half of Main Street for storm sewers, roads, curbs, sidewalk and the end of driveways.
- Following the excavations, granular material will be placed and compacted.
|
| Week of October 27, 2025 |
- Removal and replacement of concrete curb/gutters and sidewalks along the west half of Main Street.
- A few driveway culverts and driveway aprons will be replaced along the west half of Main Street.
- Excavations continuing along the east half of Main Street for storm sewers, roads, curbs, sidewalk and the end of driveways.
- Following the excavations, granular material will be placed and compacted.
|
|
Week of November 3, 2025
|
- Removal and replacement of concrete sidewalk on the west half of Main Street.
- Removal and replacement of driveway culverts on the west half of Main Street.
- Road excavations for the storm sewer installation in front of the Mount Albert Community Centre.
|
|
Week of November 10, 2025
|
- Continued road excavations for the storm sewer installations, in front of the Mount Albert Community Centre..
- Removal and replacement of concrete sidewalk sections on the east half of Main Street.
- Relocation of street signs for the west half of Main Street.
|
|
Week of November 17, 2025
|
- Continued installation of storm sewers, maintenance holes and catch basins from approximately 60 Main Street, heading east towards Centre Street.

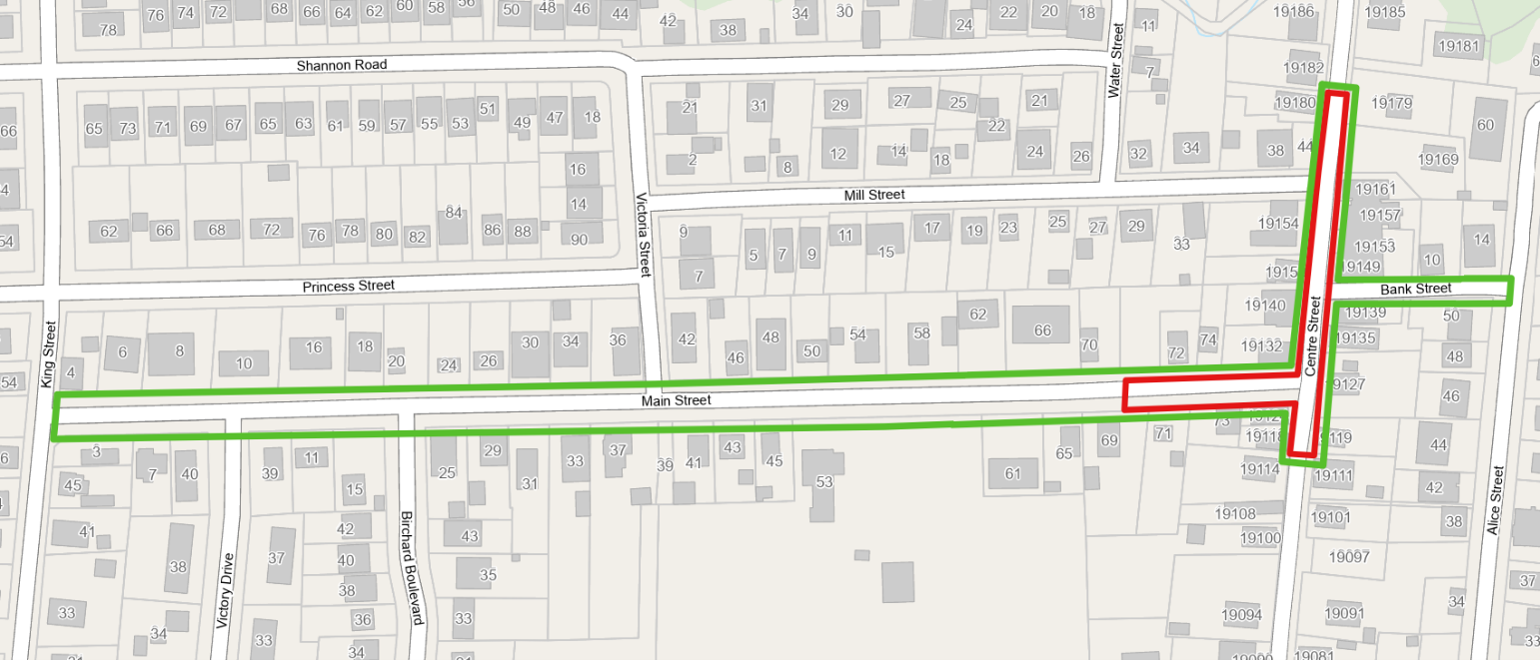

- Full depth asphalt removal for the west half of Main Street, from King Street to the Mount Albert Community Centre.
- After asphalt removals, grade the existing granular road base for the west half of Main Street.
- Maintenance hole adjustments for the west half of Main Street.
- Continued driveway culvert replacements for the west half of Main Street.
|
|
Week of November 24, 2025
|
- Installing concrete curb and gutter from the Mount Albert Community Centre, heading east towards Centre Street.
- Continue installing storm sewers, maintenance holes and catch basins from approximately 66 Main Street, heading east towards Centre Street.
- Base asphalt paving for the west half of Main Street, from King Street to the Mount Albert Community Centre.
|
| Next Steps |
- The Revitalization contractor (Primrose) has mobilized to the area as of late September 2025.

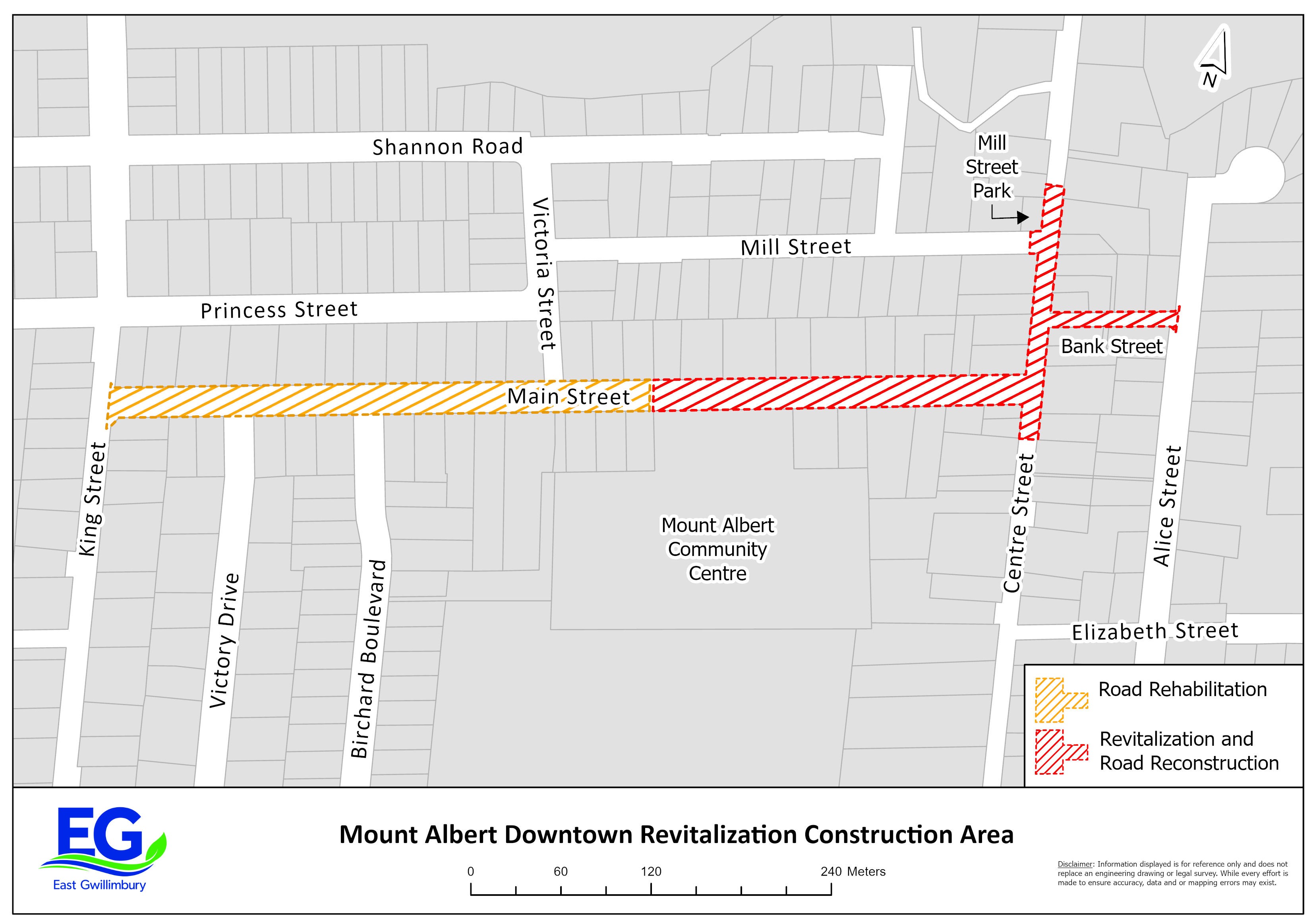

- Primrose has begun the construction activities along Main Street from Centre Street to King Street. The east half of the road is receiving revitalization scope matching the project drawings, the west half of the road is receiving a road rehabilitation matching the existing configuration, including upgraded sidewalk ramps at intersections.
- Following the completion of Main Street, the contractor is expecting to begin the revitalization scope on Bank Street later this fall, pending weather conditions.
|
